Project
Intermediate Mill Revamping
Service
Civil Detail Design and Civil works on a fast-track revamping basisLocation
ItalyYear
August 2022 + December 2022Shut-down period
12 calendar days (+ 14 calendar days (
Technological supplier
Danieli SpaFerretti Construction carried out the civil detailed design and execution of civil works for the revamping of an intermediate rolling mill in Italy, using a Fast-Track Revamping approach to ensure speed and operational efficiency.

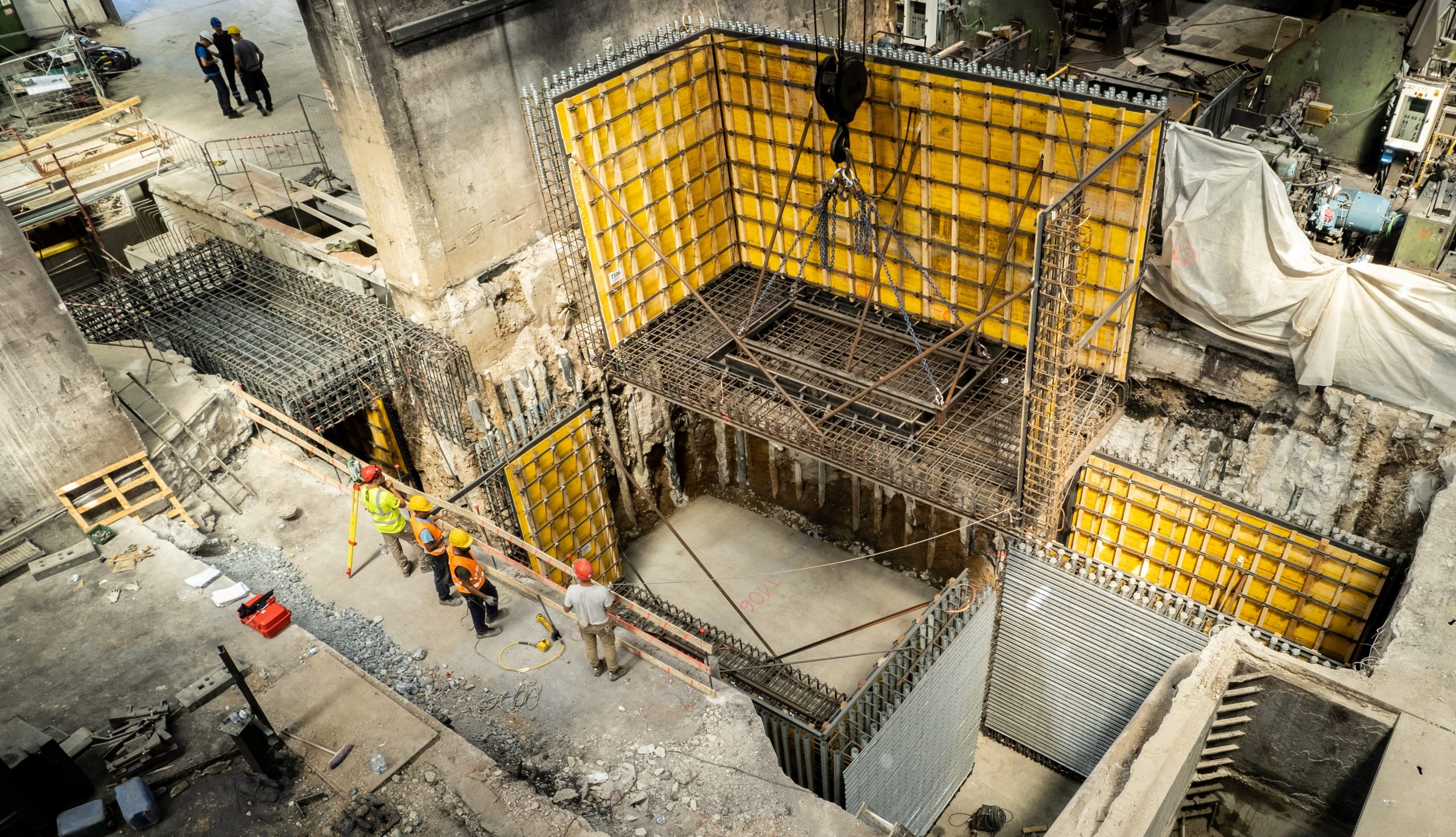

The project was executed during two scheduled shutdowns, both completed ahead of time:
- Shutdown #1: planned for 12 days, completed 3 days early
- Shutdown #2: planned for 14 days, completed 2 days early

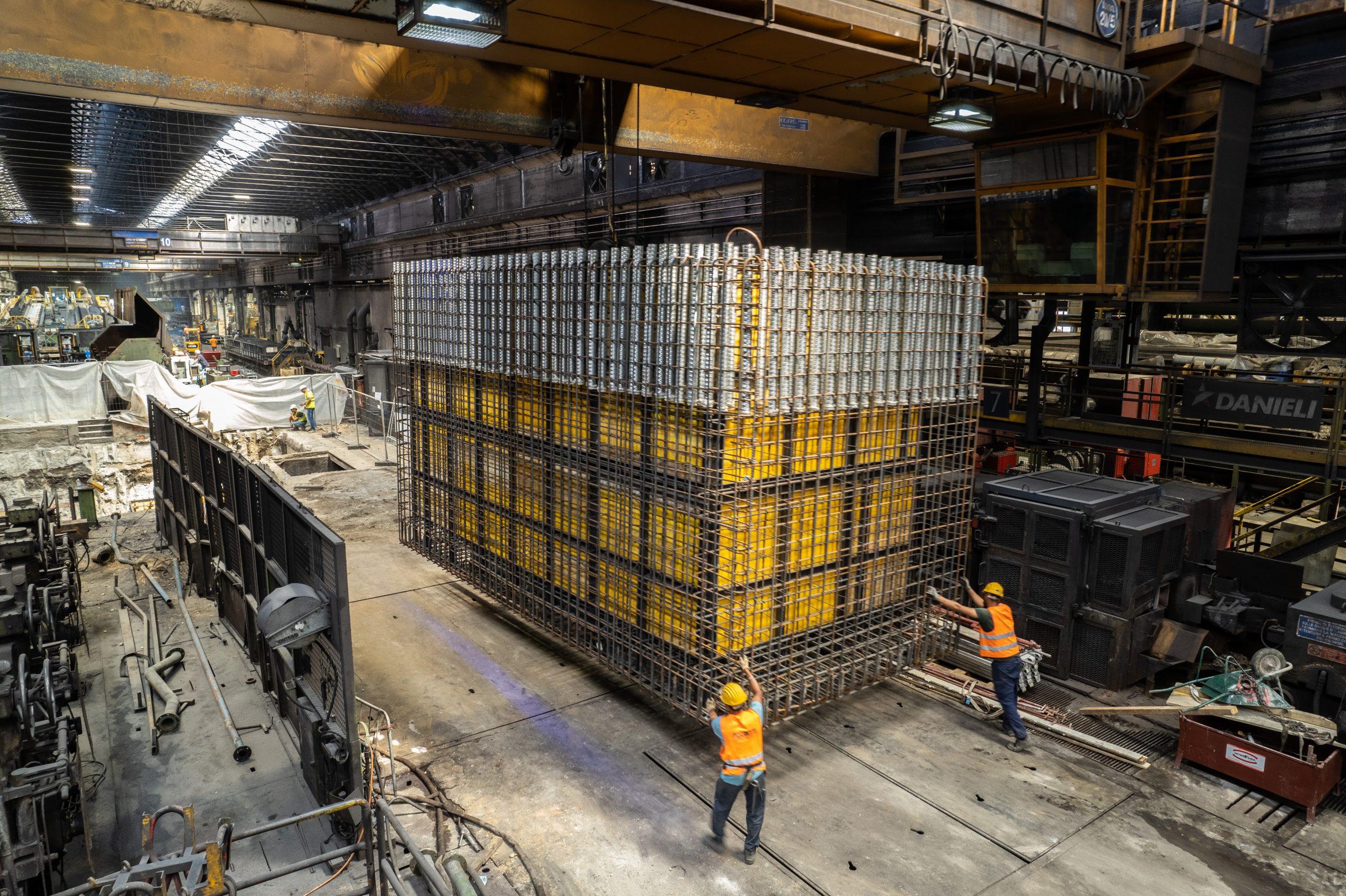

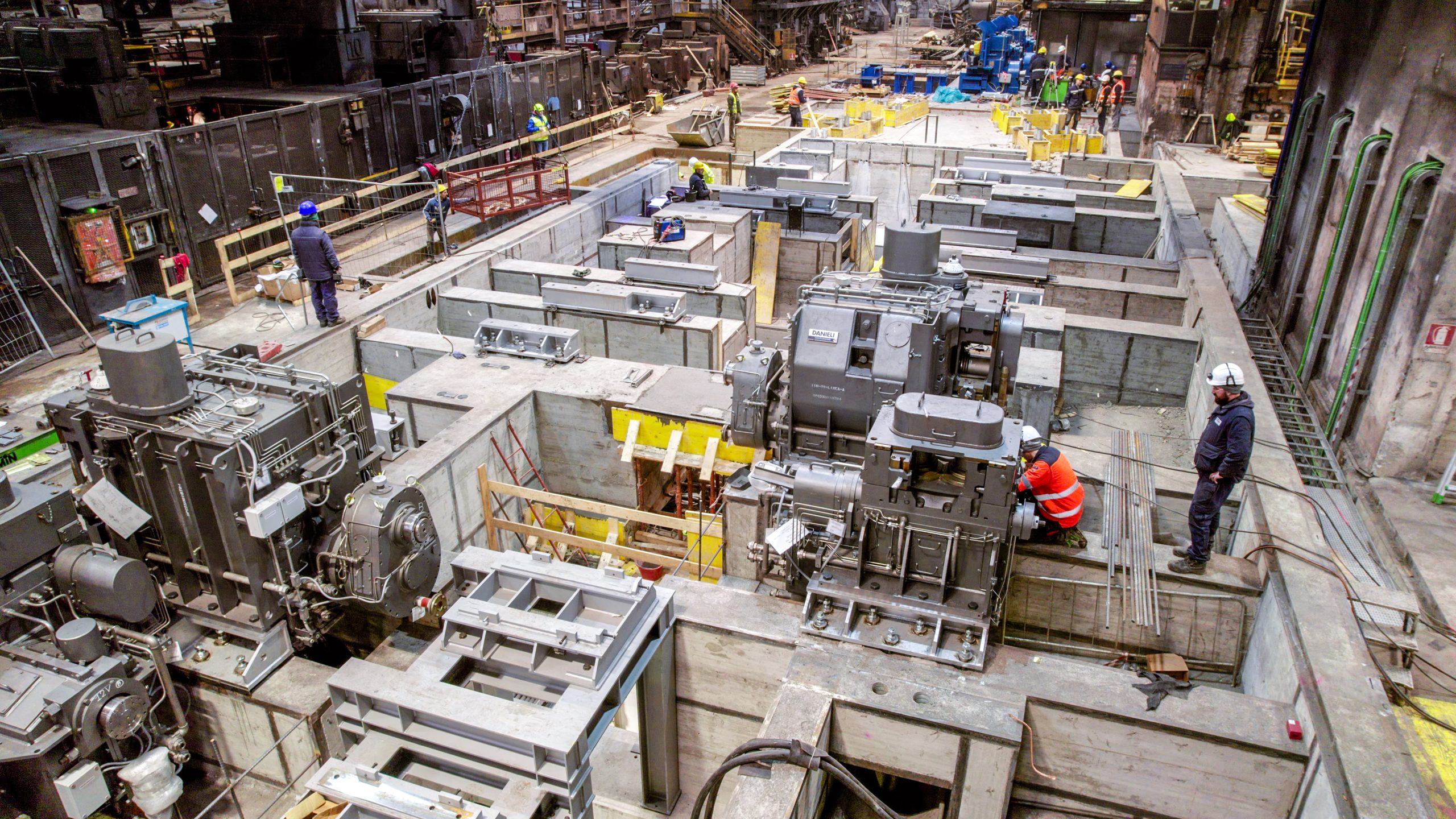

The scope of work included approximately 5.500 m³ of excavation and demolition and the casting of over 4.500 m³ of structural reinforcement concrete, all performed with high operational efficiency and strict quality control.
